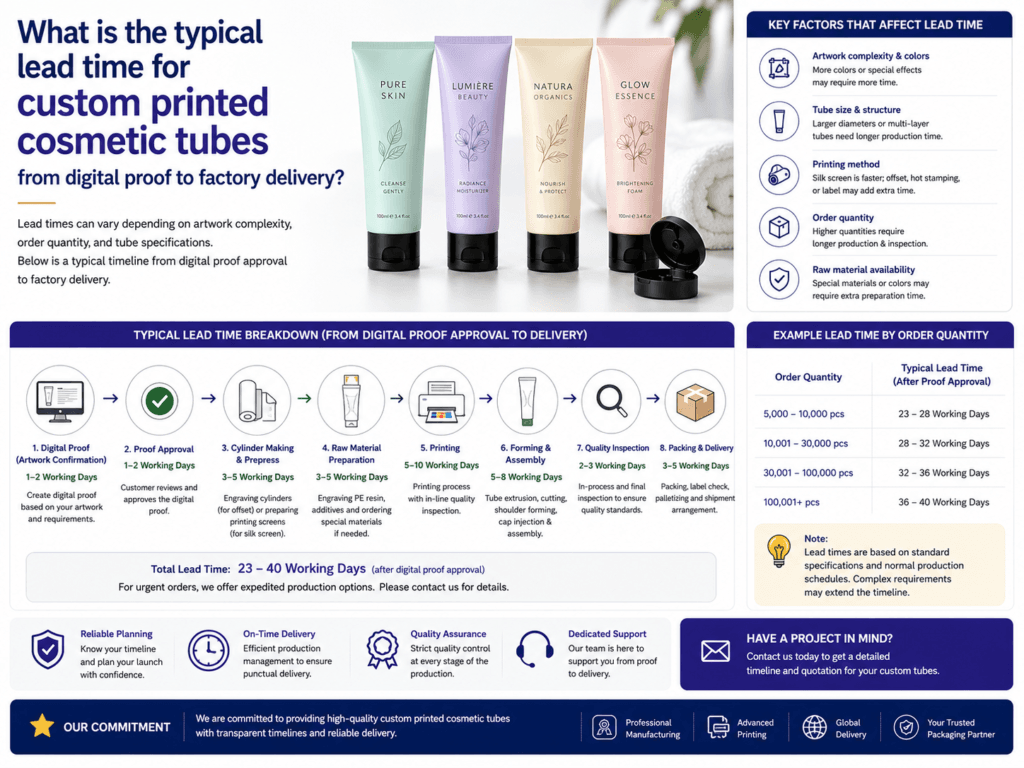

The typical lead time for custom printed cosmetic tubes is about 35–50 days from digital proof approval to factory delivery, depending on artwork complexity, tube material, printing method, cap type, sample approval, production quantity, and quality testing. If only stock molds and standard caps are used, the timeline can be shorter. If new tooling, special applicators, PCR material, EVOH barrier tubes, metallic finishes, or multiple artwork versions are required, the timeline may be longer.
For most OEM/ODM cosmetic tube projects, buyers should separate the timeline into two stages: sample development and mass production. A practical schedule is usually 7–10 working days for custom samples after digital proof confirmation and 25–35 days for bulk production after sample approval and deposit confirmation.
Quick Answer
From digital proof to factory delivery, a standard custom printed cosmetic tube project usually takes 5–8 weeks. The shortest projects use existing tube molds, standard PE material, simple printing, and standard caps. The longest projects involve custom molds, special caps, multi-color artwork, hot stamping, soft-touch coating, PCR material, EVOH barrier structures, or strict compatibility testing.
| Project Stage | Typical Lead Time | What Happens |
|---|---|---|
| Digital proof review | 1–3 working days | Artwork layout, dieline, Pantone color, printing position, and technical details are checked |
| Custom sample production | 7–10 working days | Tube body, cap color, printing, finish, and sample decoration are prepared |
| Sample approval | 3–7 days or longer | Buyer checks color, logo position, tube size, cap fit, and formula compatibility |
| Bulk production | 25–35 days | Tube extrusion, head injection, printing, cap matching, assembly, QC, and packing |
| Factory delivery / ready for shipment | 1–3 days after QC | Final inspection, carton packing, documents, and delivery to forwarder or warehouse |
What Does “Digital Proof” Mean?
A digital proof is the pre-production artwork confirmation file. It usually shows the tube dieline, logo position, print area, front and back layout, color references, cap color, tube finish, and decoration method. It is not the same as a physical sample. The digital proof confirms what the factory should prepare before sample production.
| Digital Proof Item | Why It Matters | Common Delay Risk |
|---|---|---|
| Dieline and print area | Confirms artwork fits the tube diameter and length | Artwork too close to tail seal, shoulder, or side seam |
| Pantone or CMYK color | Controls brand color matching | No Pantone code or unclear color standard |
| Printing method | Determines setup, cost, and production process | Late change from silk screen to offset or hot stamping |
| Cap and tube color | Confirms overall packaging appearance | Color approval requires several rounds |
| Finish specification | Confirms matte, glossy, pearl, soft-touch, or metallic effect | Surface effect not clearly defined before sampling |
Standard Timeline for Existing Mold Projects
If the project uses an existing tube diameter, standard shoulder, standard cap, and regular printing process, the lead time is usually more predictable. This is the most common route for skincare, sunscreen, hand cream, facial cleanser, body lotion, shampoo, conditioner, and toothpaste packaging buyers.
| Timeline | Stage | Buyer Action Needed |
|---|---|---|
| Day 1–3 | Digital proof confirmation | Approve artwork, size, material, cap, and printing method |
| Day 4–14 | Custom sample production | Wait for physical proof or sample photos/video |
| Day 15–21 | Sample review and approval | Approve color, finish, tube feel, cap fit, and logo position |
| Day 22–56 | Mass production | Confirm deposit, final quantity, carton mark, and shipping term |
| Day 57–60 | Factory delivery / ready to ship | Arrange forwarder, final payment, or pickup instruction |
Lead Time for More Complex Custom Tube Projects
More complex projects require additional development time. This includes custom tube heads, special applicators, airless pump heads, metal applicator tips, rollerballs, PCR material trials, EVOH barrier testing, special cap molds, dual-color injection caps, and premium finishes.
| Project Type | Typical Lead Time | Reason |
|---|---|---|
| Standard PE printed tube | 35–50 days after proof approval | Existing mold, normal printing, standard cap |
| 5-layer EVOH barrier tube | 40–60 days | Material structure and barrier requirements need more control |
| PCR or sugarcane PE tube | 40–60 days | Material sourcing, color stability, and testing may take longer |
| Metal applicator or rollerball tube | 45–70 days | Applicator fit, leakage, formula compatibility, and assembly tests are needed |
| Custom cap or custom head mold | 60–90 days or longer | Tooling, mold trial, fit test, and sample correction are required |
| Multiple SKUs / multiple artworks | 45–75 days | More printing setup, color matching, and QC comparison are needed |
What Happens During Bulk Production?
Custom printed cosmetic tube production is not one single step. The factory must prepare materials, extrude tube bodies, inject or attach tube heads, produce or match caps, print the artwork, apply surface finishing if needed, assemble components, inspect quality, and pack the tubes for export.
| Production Step | Purpose | Quality Control Focus |
|---|---|---|
| Material preparation | PE, PCR, EVOH, ABL, PBL, or special material is prepared | Material grade, color, batch consistency |
| Tube extrusion | Tube body is formed to required diameter and wall thickness | Diameter, wall thickness, softness, surface smoothness |
| Head injection / shoulder forming | Tube head and neck structure are made | Neck fit, thread, orifice, shoulder shape |
| Printing and decoration | Logo, artwork, coating, hot stamping, or varnish is applied | Color accuracy, registration, adhesion, scratch resistance |
| Cap matching and assembly | Caps are matched to the tube neck and design | Torque, leakage, cap color, hinge, plug seal |
| Final inspection and packing | Finished tubes are checked and packed for delivery | Quantity, appearance, carton strength, label, export marks |
Factors That Can Extend Lead Time
| Delay Factor | Why It Adds Time | How to Prevent It |
|---|---|---|
| Artwork file is not print-ready | Factory must adjust fonts, resolution, dieline, or color layers | Provide AI, PDF, or EPS vector file with outlined fonts |
| Pantone color not confirmed | Color matching may require several trials | Confirm Pantone code and acceptable tolerance early |
| Formula compatibility not tested | Packaging may need material or cap changes after sample review | Share formula type, viscosity, pH, oils, alcohol, and actives early |
| Special cap or applicator | Fit, leakage, and assembly need additional tests | Choose existing cap or applicator mold when possible |
| Multiple artwork versions | Each SKU needs separate proofing, setup, and inspection | Standardize layout and color system across SKUs |
| Peak-season production | Factory schedule and raw material supply may be tighter | Book production slot earlier |
Printing Method and Lead Time Differences
Different decoration methods have different setup requirements. Simple one-color silk screen printing is faster than multi-color artwork with hot stamping and soft-touch coating. Premium finishes require more drying, curing, testing, and inspection time.
| Printing / Decoration Method | Lead Time Impact | Best Use |
|---|---|---|
| One-color silk screen printing | Shorter | Minimalist skincare, hand cream, hotel amenities |
| Multi-color silk screen printing | Medium | Premium logo and simple graphic designs |
| Offset printing | Medium | Full artwork, gradients, larger coverage |
| Hot stamping | Medium to longer | Gold, silver, or metallic logo highlight |
| Matte / soft-touch coating | Longer | Premium skincare, sunscreen, gift-set packaging |
| Label or shrink sleeve | Project-specific | Small batches or complex full-wrap graphics |
How Sample Approval Affects the Timeline
Sample approval is often the stage where timelines become longer. If the buyer requests a color change, logo repositioning, cap replacement, or finish adjustment, the sample process may restart. This is why a clear digital proof and precise specifications are important before sampling.
| Sample Feedback | Timeline Impact | Recommendation |
|---|---|---|
| Approve sample directly | Production can start quickly | Best case for launch schedule |
| Minor artwork adjustment | Adds several days | Confirm final file before plate or screen setup |
| Color correction | May add 5–10 days or more | Use Pantone references and physical color standards |
| Cap or material change | May add 1–3 weeks | Confirm cap function and formula needs before sampling |
| New mold or applicator change | Can add several weeks | Review all technical requirements before mold development |
Factory Delivery vs. Final Arrival Time
Factory delivery means the goods are finished, inspected, packed, and ready to be picked up by the buyer’s forwarder or delivered to the agreed shipping point. It does not always mean the tubes have arrived at the buyer’s warehouse. International shipping time must be calculated separately.
| Term | Meaning | Buyer Should Confirm |
|---|---|---|
| Factory delivery | Goods are ready at the factory or sent to the local forwarder | Pickup date, carton details, final QC report |
| FOB delivery | Goods are delivered to port and loaded according to trade terms | Port, vessel schedule, export documents |
| Air freight arrival | Faster international transport | Higher cost, useful for urgent launches |
| Sea freight arrival | Lower cost but longer transit time | Plan extra time for customs and local delivery |
How to Shorten the Lead Time
- Use existing tube molds: Standard diameters and caps avoid tooling delays.
- Prepare print-ready artwork: Provide vector files, outlined fonts, Pantone codes, and correct dielines.
- Limit decoration complexity: Fewer colors and fewer finish layers reduce setup and inspection time.
- Approve standard cap options: Existing screw caps, flip-top caps, or nozzle caps are faster than custom caps.
- Share formula details early: Viscosity, pH, oils, alcohol, actives, and filling temperature affect material selection.
- Approve samples quickly: Delayed feedback extends the total schedule.
- Confirm shipping term early: Avoid delays caused by missing forwarder information or carton requirements.
Recommended Timeline Planning for Buyers
| Launch Situation | Recommended Planning Window | Reason |
|---|---|---|
| Standard reorder | 4–6 weeks before needed date | Artwork and tooling are already approved |
| New standard custom tube | 6–8 weeks before factory delivery target | Needs proof, sample, approval, and production |
| New premium tube with special finish | 8–10 weeks | More decoration and QC steps are required |
| Custom mold or applicator project | 10–14 weeks or longer | Tooling, trial, correction, and fit testing are needed |
| Retail launch with strict deadline | Add buffer time | Protects against sample changes, freight delays, and inspection issues |
Common Mistakes to Avoid
- Counting only mass production time: Sample development and approval can add 2–3 weeks or more.
- Changing artwork after proof approval: This may require new plates, screens, or color trials.
- Ignoring formula compatibility: Material or cap changes after testing can extend the timeline.
- Using special caps without fit testing: Cap leakage or thread mismatch can delay production approval.
- Forgetting shipping time: Factory delivery is not the same as warehouse arrival.
- Not confirming carton marks and packing: Export packing details can delay final delivery.
Best Practical Recommendation
For most custom printed cosmetic tubes, plan 7–10 working days for sample production and 25–35 days for bulk production after sample approval. If the project requires custom tooling, special applicators, PCR material, EVOH barrier, metallic decoration, or multiple SKUs, add extra buffer time.
To keep the schedule stable, prepare final artwork, confirm Pantone colors, select tube material and cap type early, share formula details, approve samples promptly, and confirm packing and shipping requirements before production starts.
Summary
The typical lead time for custom printed cosmetic tubes from digital proof to factory delivery is usually 35–50 days for standard projects using existing molds and common decoration methods. Complex projects may take 45–90 days or longer, depending on tooling, applicators, material trials, printing complexity, testing, and approval rounds.
Buyers should not count only the production days. A realistic timeline includes digital proof approval, sample production, sample review, material preparation, tube extrusion, printing, cap matching, quality inspection, packing, and factory delivery.
Learn more: Custom Cosmetic Tubes, Printing Design, Printing Options, Sample Development, Quality Assurance, Customization.
